Baseline is an original project plan or reference point used to track progress of the project. Task planning object enables you to create many baselines for the project at different phases (given that the Task planning object is linked to the particular phase) so that you can compare your current progress against your initial baseline.
This option will be available depending on the configurations done by your IPM administrator.
Baselines start/end dates (for each phase that the Task planning object is linked to) and the project start/end dates are displayed at the top of the Gantt chart
![]() |
|
To create a baseline,
STEP 1: Save the current view by clicking the ‘Save’ icon

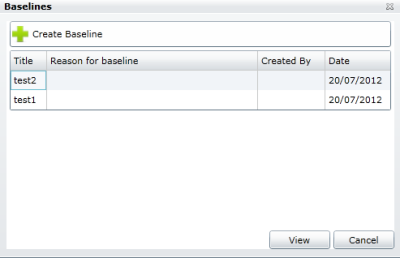

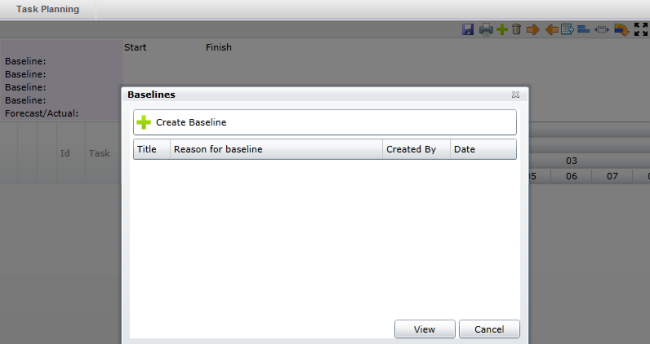

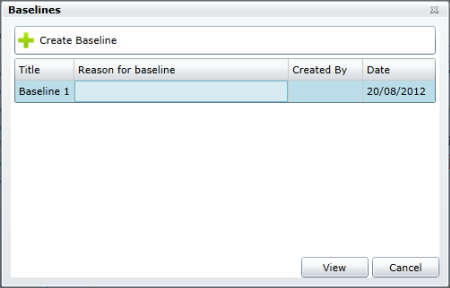

STEP 2: Click on the ‘Baseline’ icon. A pop-up window will open with a list of baselines created.

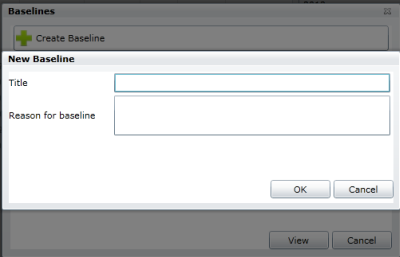

STEP 3: Click ‘Create a baseline’. Define a ‘Title’ and provide a reason for baseline if required.

STEP 4: Click ‘OK’ to save the baseline.
![]() |
|
To view a baseline,
STEP 1: Click on the baseline icon and select the baseline that you need to view.

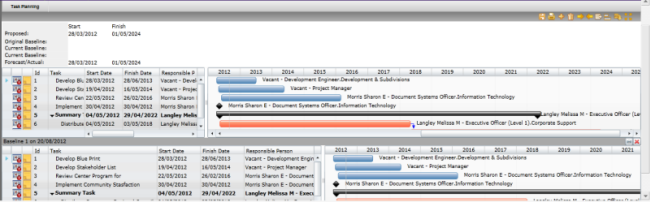

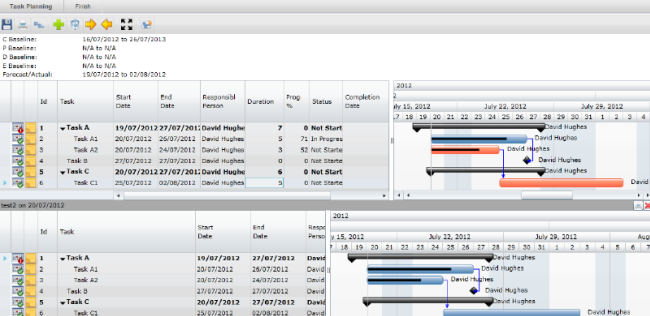

STEP 2: Click ‘View’. This would display on a split screen where you can see the current view on top and the baseline view at the bottom. You will not be able to edit any information in the baseline view.
